Home Industry Projects

Lessons from Boston’s Big Dig megaproject

Larissa Foster by Larissa Foster
4 September 2025
in Projects, Features
Reading Time: 4 mins read
1
Lessons from Boston’s Big Dig megaproject

Boston’s Zakim Bunker Hill Bridge, built as part of the Big Dig project. Video: Getty

Boston’s Central Artery Tunnel Project, more commonly known as the Big Dig, was one of the largest and most technically challenging highway projects in United States history.

Cutting through the heart of the Massachusetts capital, the massive urban infrastructure project commenced in 1991. It involved moving the city’s six-lane elevated Central Artery (Interstate 93) underground to alleviate traffic congestion, reconnect downtown Boston to the waterfront and improve access to Boston Logan International Airport.

An unprecedented scope

The need for the project was clear. Boston’s Central Artery carried about 75,000 vehicles a day when it opened in 1959 – but that had risen to 200,000 by the early 1990s, making it one of the most congested highways in the US. The highway also effectively cut the city in two. Blocking off the waterfront created an urban eyesore and lack of social and economic utility.

The Big Dig’s enormous scale and complexity have seen it likened to projects such as the Panama Canal and the English Channel Tunnel. At 12.55 km long, with half of that in tunnels, it replaced the six-lane elevated highway with an underground expressway finishing in a 14-lane, two-bridge crossing of the Charles River. It also involved the construction of four highway interchanges.

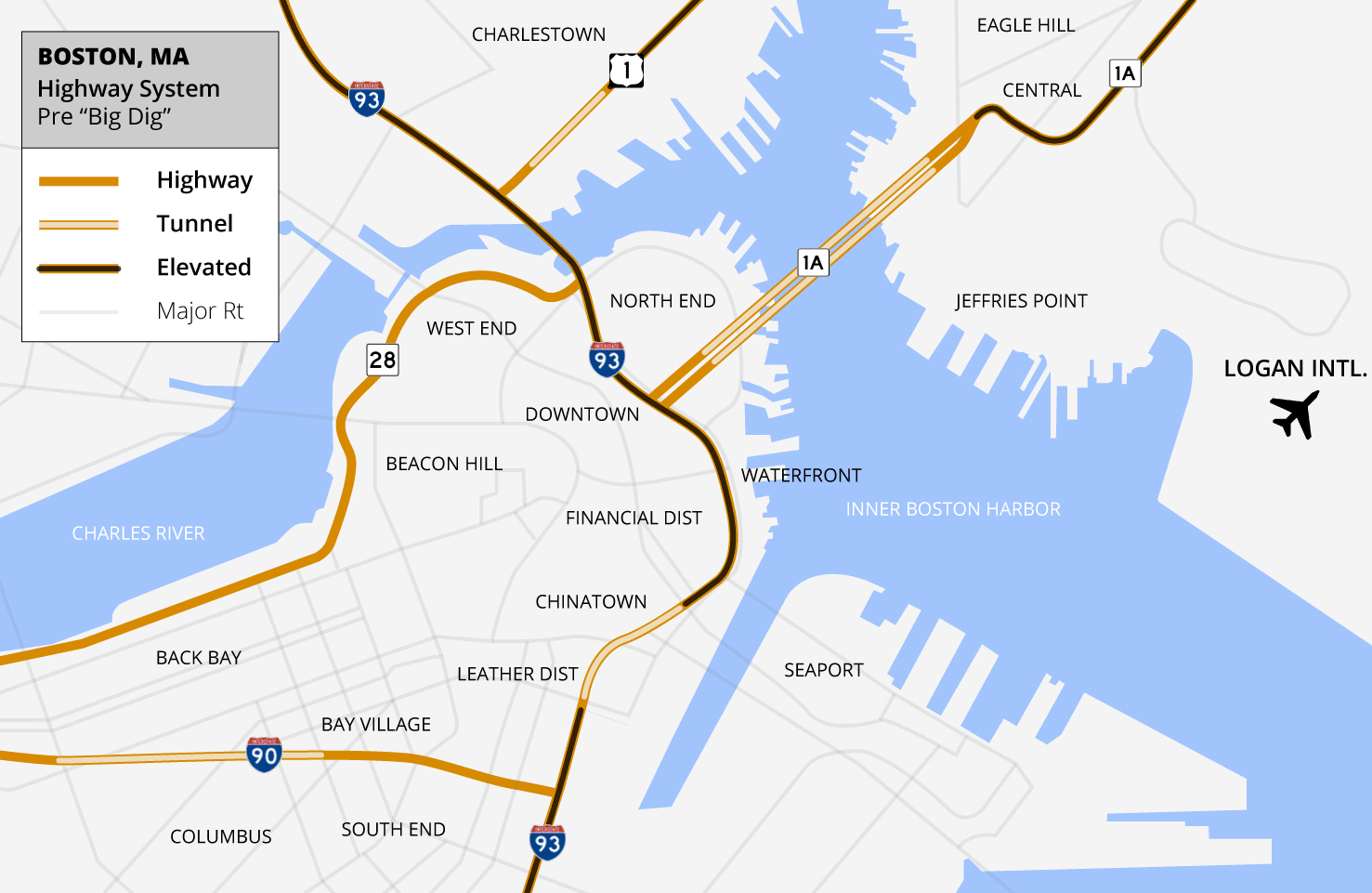

Boston’s highway system before and after the Big Dig. MrJARichard, CC BY 4.0 <https://creativecommons.org/licenses/by/4.0>, via Wikimedia Commons

As well as the incredible scope – more than 8000 km of fibre-optic cable and 322,000 km of copper cable were installed – the project commanded a list of engineering firsts. It saw the deepest underwater connection and the largest slurry-wall application in North America. Hundreds of pipes carrying cold brine were used to freeze the soil beneath nine existing rail lines; these kept it from collapsing while the area was excavated before a concrete tunnel built off-site was “tunnel-jacked” into place.

The world’s widest cable-stayed bridge, the Zakim Bunker Hill Bridge, spanned the Charles River, and its largest tunnel-ventilation system was installed underground.

A success – at what cost?

The project was hailed a success after its completion, with a study by the Massachusetts Turnpike Authority finding it cut the average car trip through Boston from almost 20 minutes to under three minutes.

However, the construction saw Boston suffer through years of traffic jams, and blowouts led to the project taking more than 15 years to complete. Construction began in 1991 and was officially finished in 2007, while the initial cost estimate escalated from just under AUD$4 billion to more than $23 billion.

Reported reasons for this included inflation, the failure to assess unknown subsurface conditions, and extensive environmental and mitigation costs.

“The sheer size of this project and the fact that construction occurred in a busy city resulted in having to deal with many unanticipated conditions.”
Boston University

Multiple stakeholders were another complicating factor. One Big Dig program required the relocation of more than 46 km of utility lines such as gas, electricity, telephone, sewer and water, which were maintained by 31 separate companies.

Boston University’s Mega-Project Research Program concluded that no single event caused Big Dig costs to escalate.

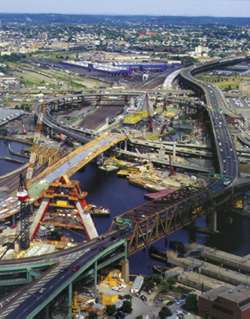

Boston’s Big Dig from the air. Image: “Along the Road’, July/August 2000, Public domain, via Wikimedia Commons

“The critical cause was a lack of experience and knowledge about dealing with the complexity and uncertainty that giant projects bring with them,” it said. “The sheer size of this project and the fact that construction occurred in a busy city resulted in having to deal with many unanticipated conditions and a large volume of claims and changes.”

Surprises encountered on the project included uncharted utilities, ground-water conditions, environmental problems, weak soil and hazardous materials. The discovery of Revolutionary-era sites and Native American artifacts was another delaying complication.

A simple error, devastating results

A small detail led to a fatal accident that occurred when the concrete ceiling panels in one tunnel collapsed on a car in 2006, killing a passenger.

The subsequent investigation by the National Transportation Safety Board (NTSB) found builders had used the wrong epoxy to hold the anchor bolts in place.

The builders had tested the strength of the bolts during construction; however, when some failed, the problem was attributed to installation errors rather than the breakdown of the epoxy.

A variety of other problems were identified by the NTSB in how the epoxy was mixed and used, but these did not reduce the strength enough to cause the bolts to pull out of the concrete, the investigation found.

“It’s kind of ironic [that] in a $14 billion project about $1.50 per anchor is what ended up bringing the ceiling down,” one NTSB member told The New York Times.

The supplier of the epoxy later noted the specialised fast-set product was not intended for long-term use, but that information was “in the fine print”, the NTSB said.

In a devastating failure of engineering, no one noticed that the product would weaken over time, and no regular safety inspections of the panels had occurred in the three years following the tunnel’s opening.

READ: What caused the I-35W Mississippi River bridge to collapse?

The project’s legacy

After the underground highway opened to traffic, the elevated artery was demolished to make way for open space and low-rise development. At the project’s completion in 2007, more than 45 parks and major public plazas had been created, including the seven-hectare Rose Fitzgerald Kennedy Greenway.

Critics of the Big Dig, however, continue to point to the flawed execution and huge price tag as salient lessons for future road megaprojects.

On small-scale and larger projects, engineering innovations are speeding up construction. Learn how it’s impacting project earthworks at this Engineers Australia webinar.

Tags: constructionmegaprojectsUnited States
Previous Post

The familiar problem eating away at renewable energy efforts

Next Post

Model-Based Design: proving the ROI for engineers

Larissa Foster

Larissa Foster

Related Posts

New engineering competency standard set to meet industry demands
Career

New engineering competency standard set to meet industry demands

27 August 2026
How smart glasses technology could aid visually impaired people
Features

How smart glasses technology could aid visually impaired people

25 August 2026
Are machine swarms the future of robotics?
Features

Are machine swarms the future of robotics?

25 August 2026
Next Post
Model-Based Design: proving the ROI for engineers

Model-Based Design: proving the ROI for engineers

Comments 1

  1. John Reilly, MIEA, PE, CPEng (Ret), Boston says:
    12 months ago

    A good summary of the project, its complexity, and impressive use of advanced technology. Boston has appreciated the benefits of the urban landscape that has been opened up, with new amenities, and the traffic benefits are clear. The initial cost was way underestimated and many potential risks were not identified. To address this problem, a process using probabilistic risk-based validated cost estimates was developed by the Washington State Department of Transportation (CEVP 2002) to better estimate the cost of major, complex infrastructure programs and is now used for many major US infrastructure programs. A National Academies report on the Big-Dig cost overrun noted that, if the CEVP process had been used, many of the subsequent problems might have been identified and addressed in good time

    Reply

Leave a Reply Cancel reply
